One of the only things we know for certain in any construction project is that things are going to change. The owner changes their mind, the price of materials changes, things get installed incorrectly, or unforeseen circumstances arise.
Documenting and managing change is vitally important in construction, because any change typically involves money, and at the end of the day someone has to pay for it. This is where Procore comes in.
Budget changes are a type of change that involve moving money from one budgeted line to another. Some common use cases for budget changes are balancing over- and under-budget lines at the end of the month, or moving money from contingency to cover an increase in cost.
-Customers, referring to the 1.0 experience
Uggh… not intuitive
It’s a lot more keying.
How do you know [this line] is going ‘from’?
I came onto the project full time just in time to see it through a GA release.
In the months following release, we received a ton of feedback from customers who were working adopt budget changes. While this was a highly requested feature, we noticed that many customers were encountering usability issues.
Budget changes are composed of two main elements. The adjustment is a grouping of one or more lines that indicate where money is going to and coming from. An adjustment line is the individual line within the adjustment.
One budget change can have as many adjustment and adjustment lines as needed.

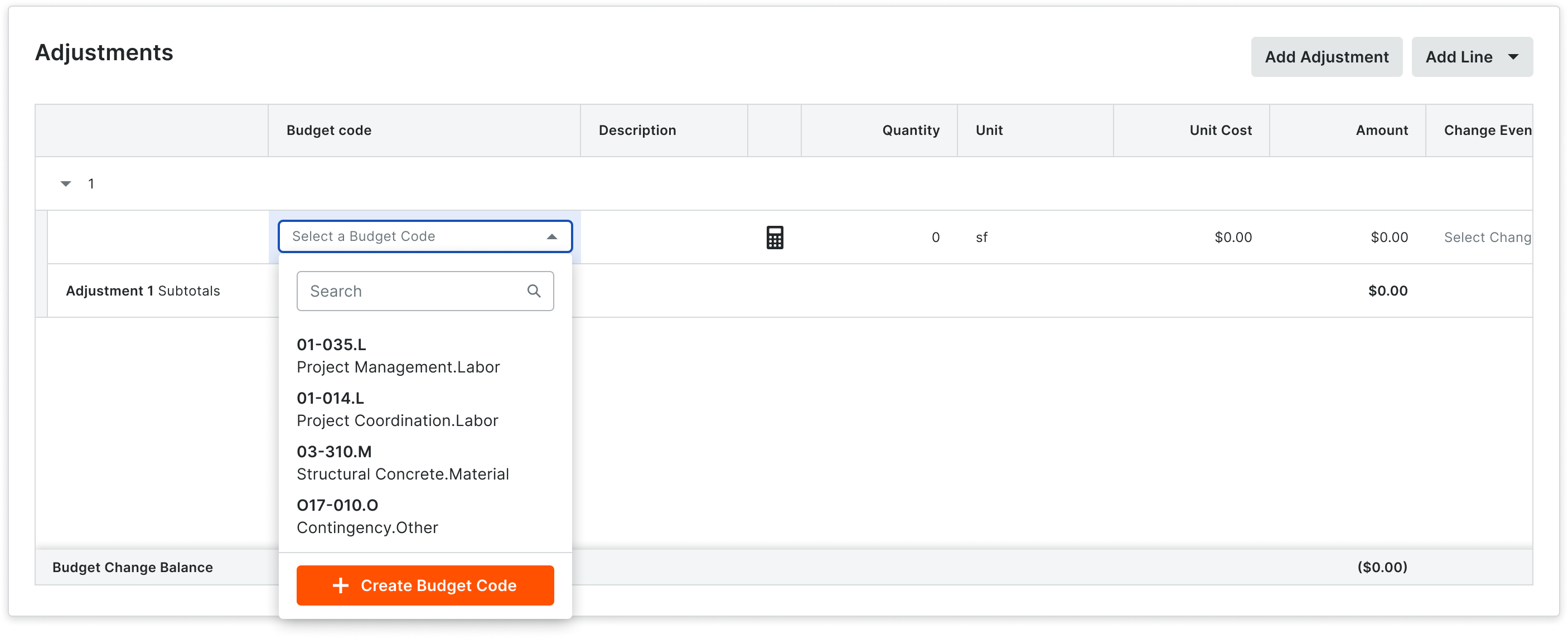

Above: a screen recording of an actual customer attempting to use the 1.0 experience
Although the team had not planned on actively developing new features for budget changes after the initial release, it became clear that we needed to improve it before our customers were fully satisfied.
From this feedback, a few themes started to emerge.

Over the next few quarters I worked with product and engineering, as well as our implementation and customer support teams on a variety of improvements.

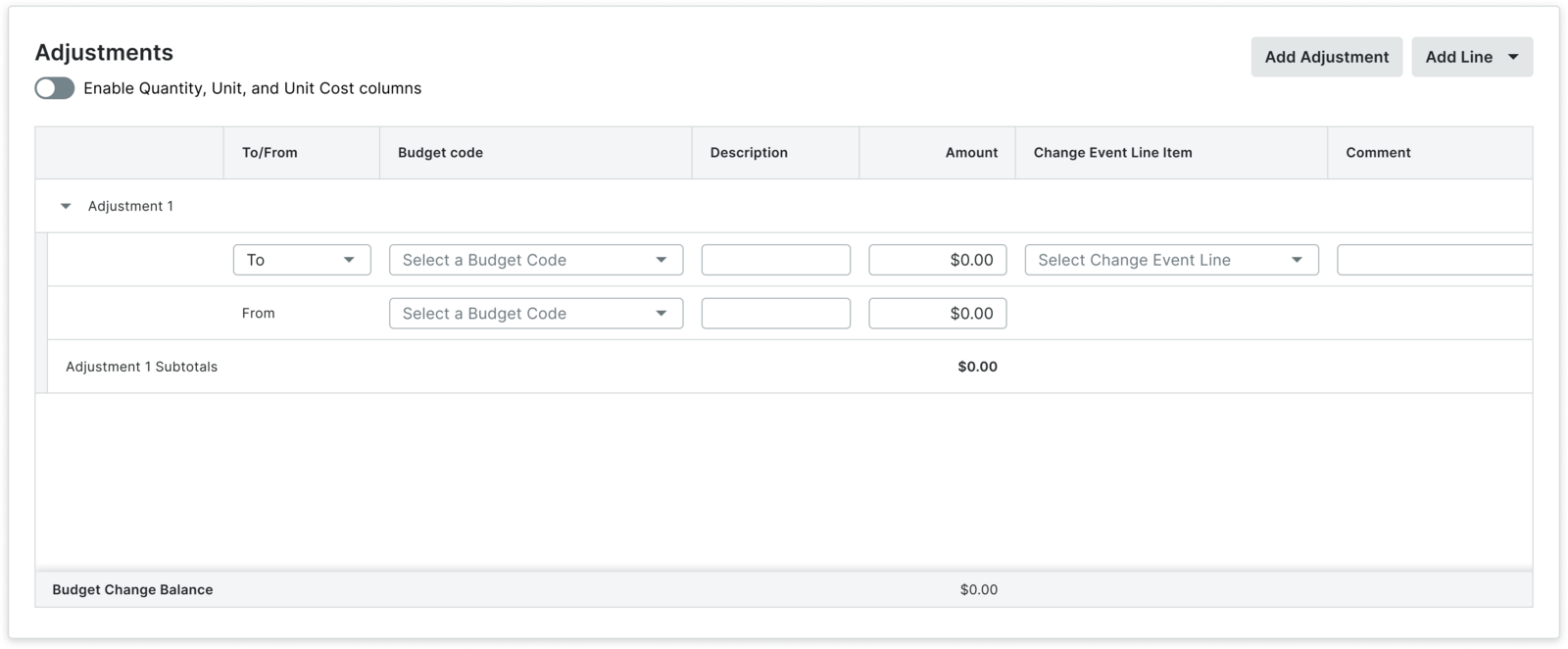

Budget changes 1.1 table

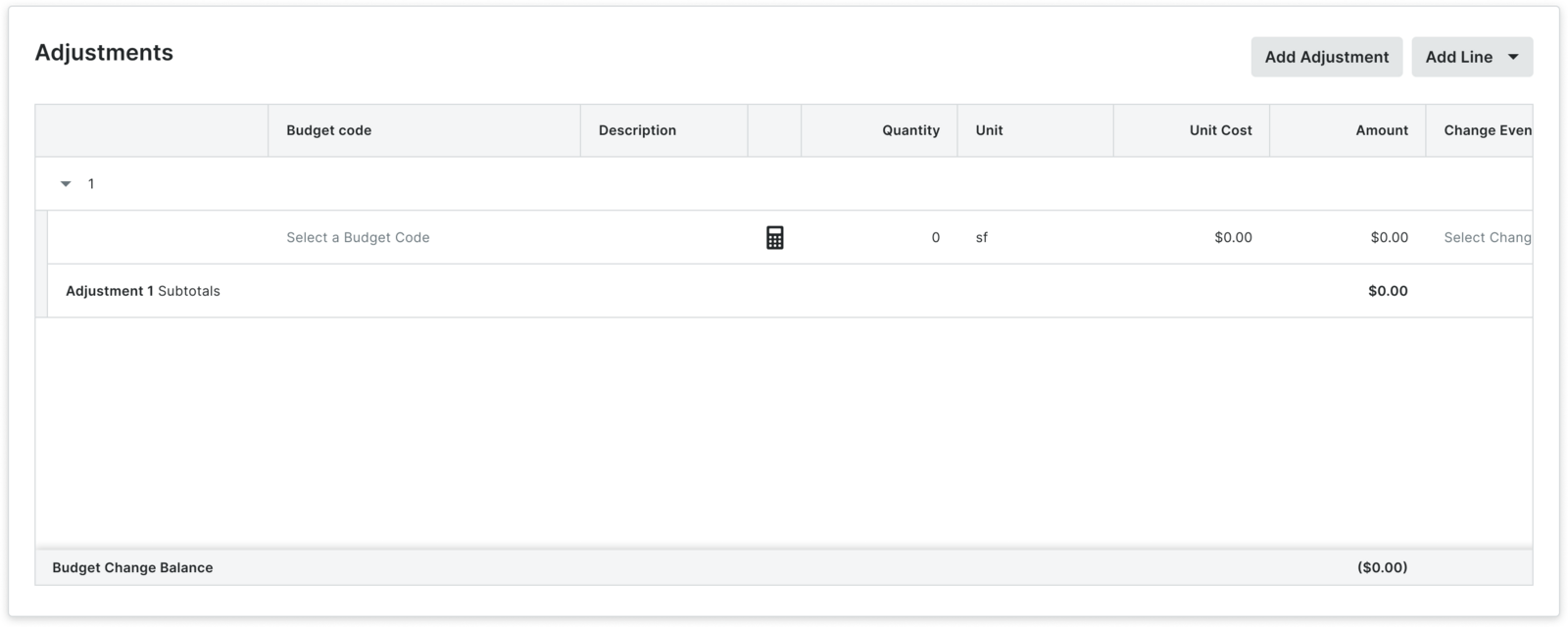

Budget changes 1.0 table

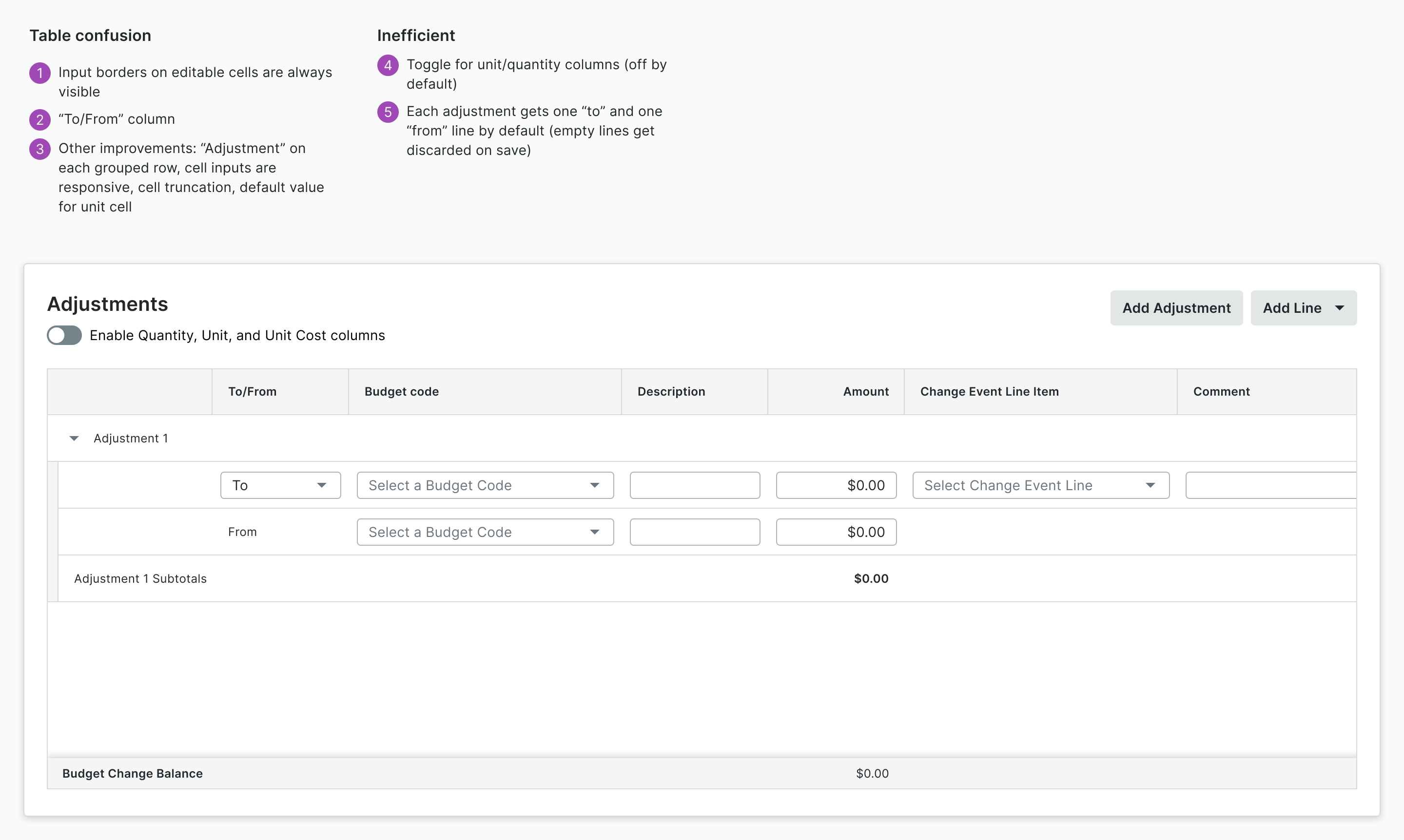

A few of the noteworthy changes:

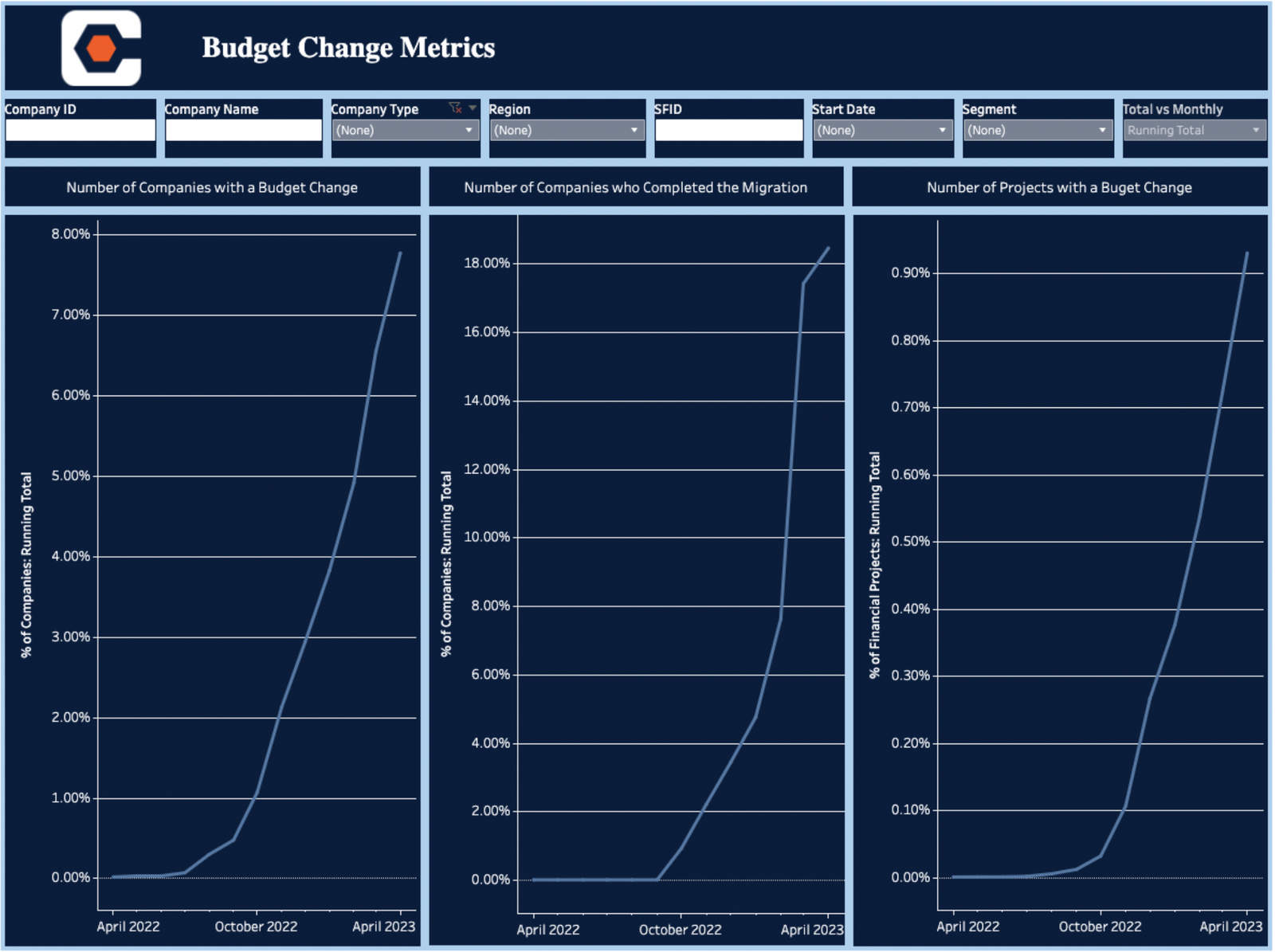

Because there were so many usability issues with the initial release, we wanted to be sure that we tested the new designs thoroughly.

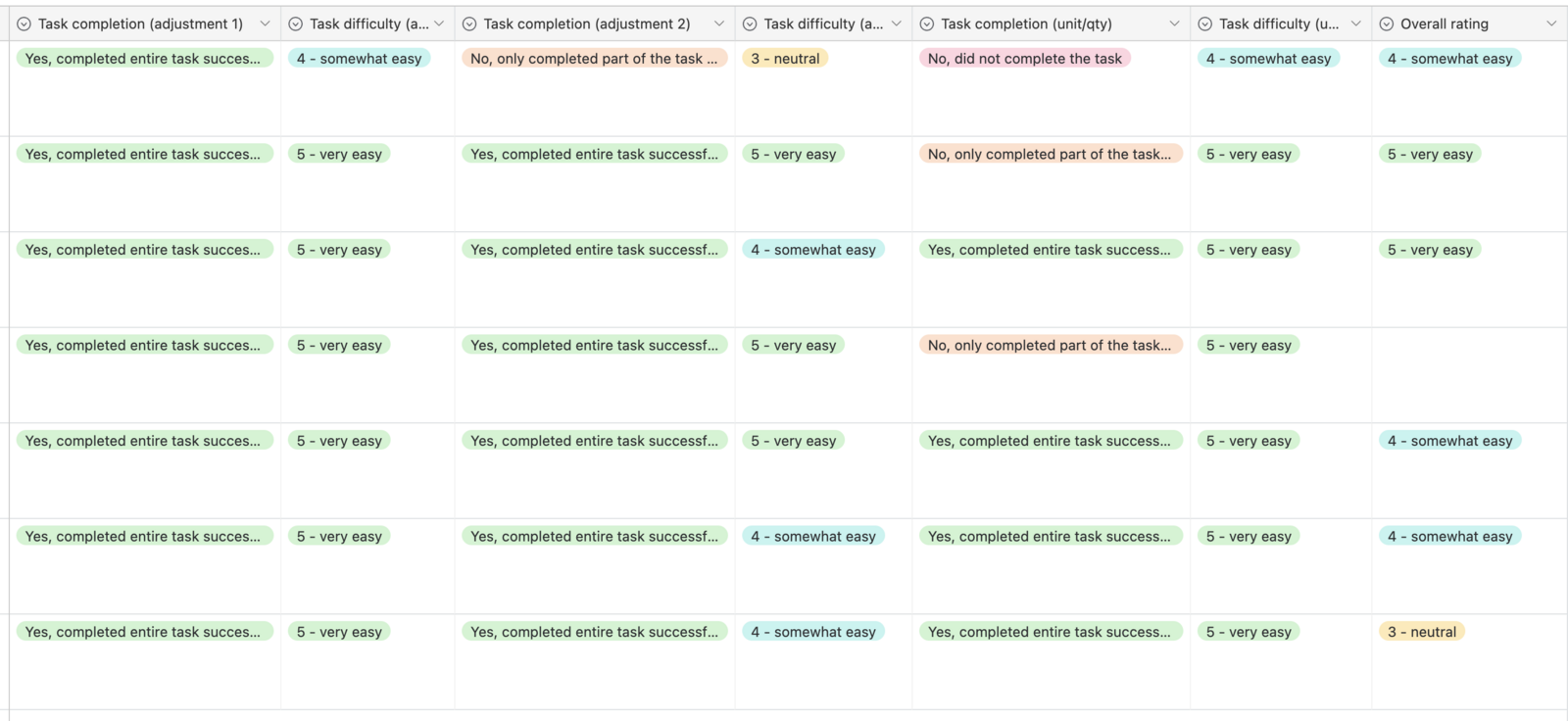

Customers were asked to complete several tasks related to creating a budget change and rate the difficulty of each task. Facilitators also rated participants on task completion.
Across all tasks, the majority of participants successfully completed the task, and rated as somewhat or very easy.
-A customer after previewing the 1.1 changes
What you’ve shown me takes away so many of my complaints.

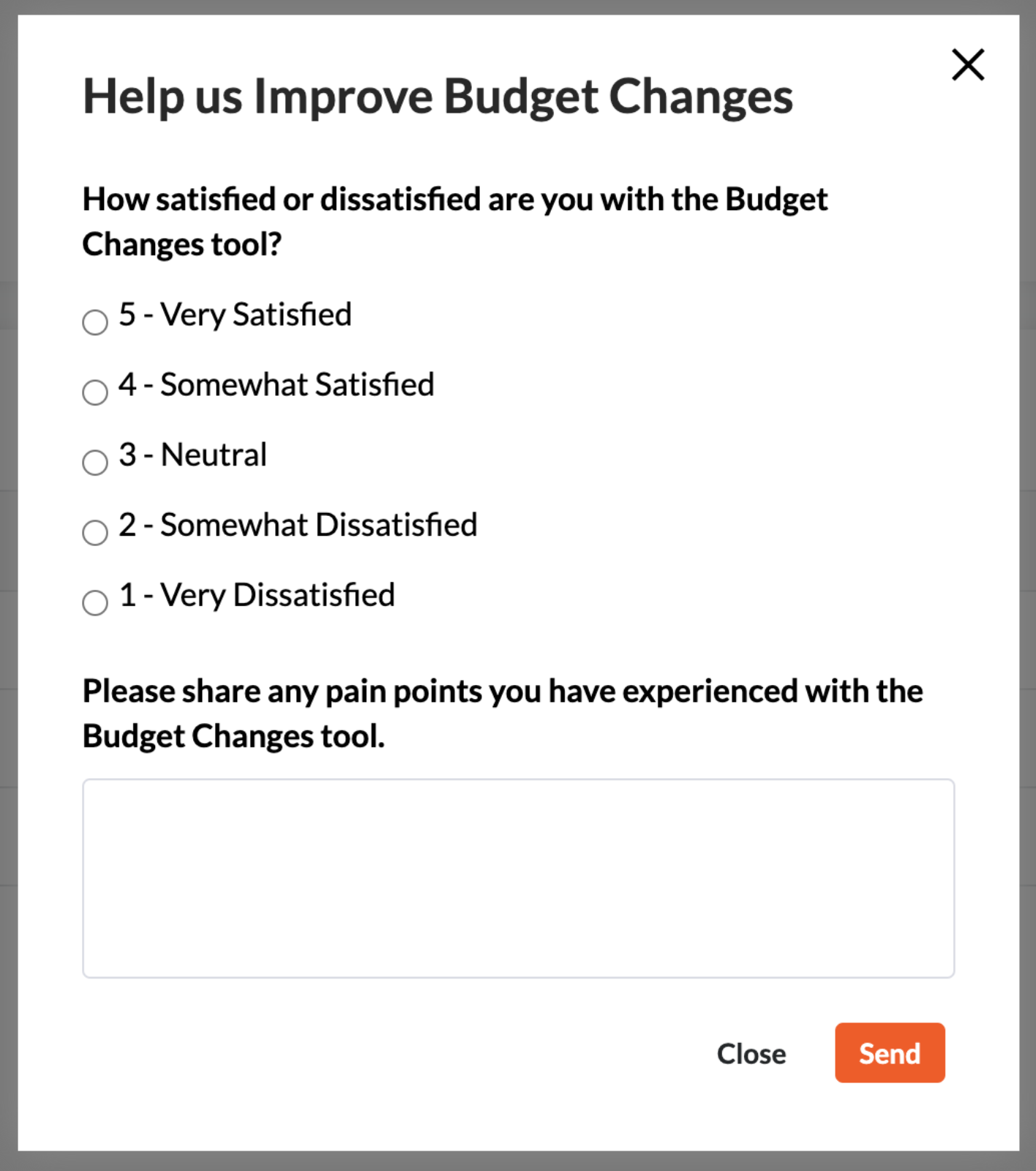

Once the 1.1 changes are released, we will be monitoring our success metrics of customer satisfaction score (CSAT), overall adoption, conversion, and time to create. Based on initial qualitative feedback we are confident that these metrics will increase across the board!
